On July 31, 2021, Schroeder celebrated its 1000th client, presenting Jason and Susie Fehr with a Certificate of Achievement and a surprise party complete with food, champagne, balloons and a heap full of fun and expressed appreciation!

1000th Clients  Refreshments  1000th client celebration

Since that day, we’ve been moving forward with the Fehr’s whole house remodel, which they are graciously allowing us to share with you as we progress through each phase of the remodel, from design through construction.

Due to a few weather and permitting delays, we broke ground early February. To launch our project start we set up a time lapse camera, which we will be sharing with you upon job completion.

The scope of this project includes a new, large rear addition with a basement and a second floor, which not only expands the size of the home, but allows the homeowners to enjoy modern conveniences and thoughtful design finishes.

Basement:

  • New Game Room
  • New Guest Bedroom
  • Renovated Basement Bath

Main Floor:

  • Large Kitchen and Family Room
  • New Mudroom with Closet Factory cabinetry
  • New Kids’ Study
  • New Powder Room
  • Renovated Living Room
  • One Car Garage
  • New Covered Front Porch

Second Floor:

  • Owner’s Suite with a large Walk-In Closet
  • Owner’s Bath with a large 12-ft shower
  • Second suite with a study and a bathroom
  • Two additional bedrooms with a Jack and Jill bathroom\

Project Photos:

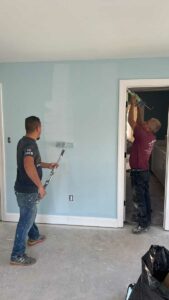

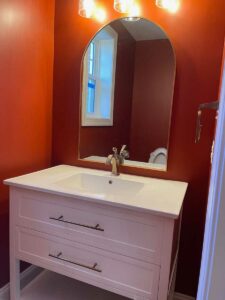

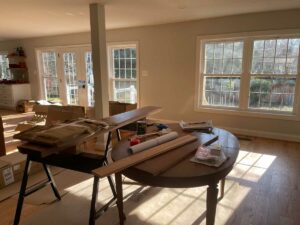

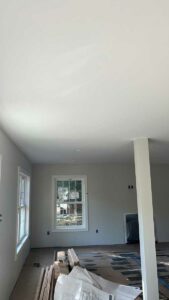

10: Completing interior finishes and painting

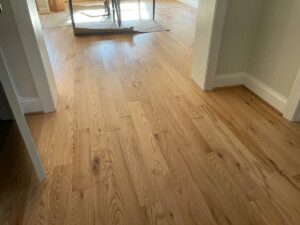

bathroom paint and installation  painting  interior door installation  floor installation floor installation  hardwood flooring

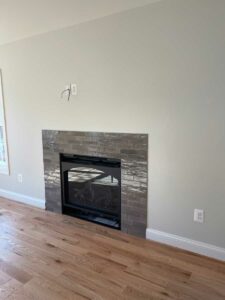

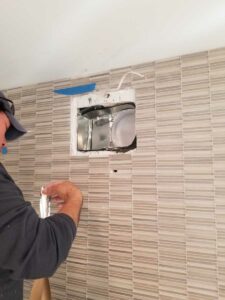

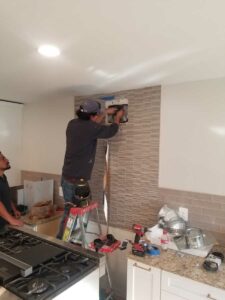

fireplace  Stove Vent Installation  Stove Vent Installation

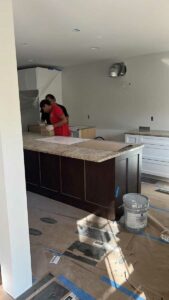

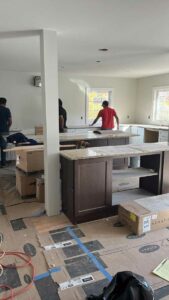

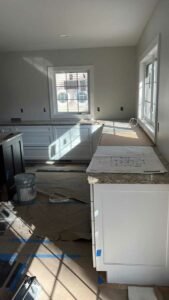

9: Kitchen & Bathroom cabinetry installation
countertop installation  countertop installation  countertop installation

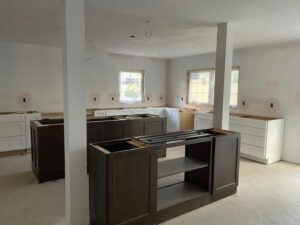

Kitchen Cabinetry Installation  Kitchen Cabinetry Installation

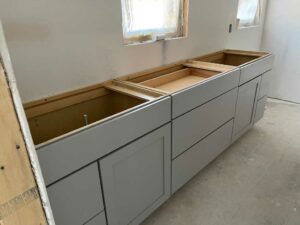

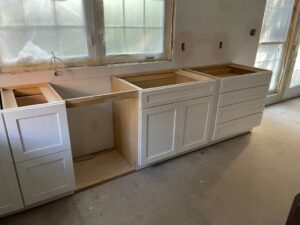

Bathroom Cabinetry Installation  Bathroom Cabinetry Installation

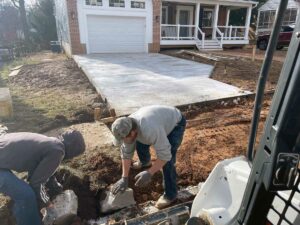

8: The new porch and driveway are installed
new porch and driveway  new porch and driveway
new porch and driveway

7: Brick columns added to the front of the garage wall

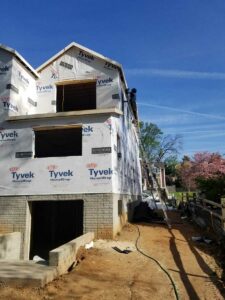

Brick columns added to the front of the garage wall  Brick columns added to the front of the garage wall  Completing the framing of the room addition - Exterior

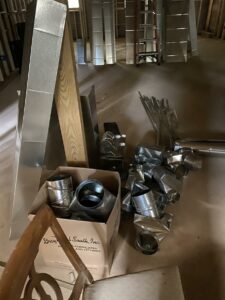

6: HVAC Rough-In
HVAC Rough-In  HVAC Rough-In
HVAC Rough-In  HVAC Rough-In

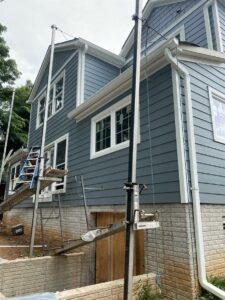

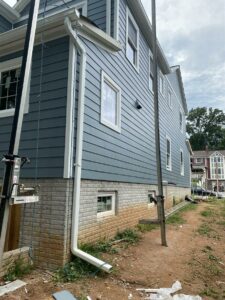

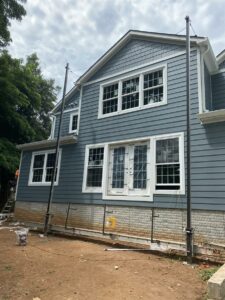

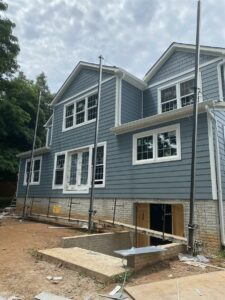

5: Siding installed on Room Addition
Siding installed on Room Addition  Siding installed on Room Addition
Siding installed on Room Addition  Siding installed on Room Addition

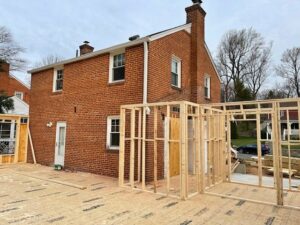

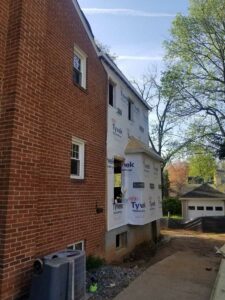

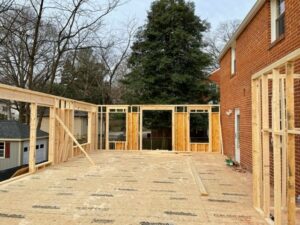

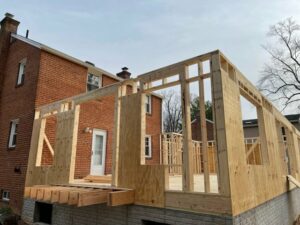

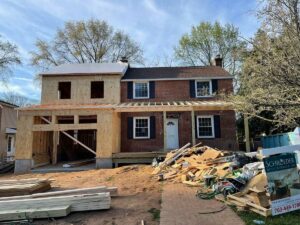

4: Completing the framing of the room addition
Completing the framing of the room addition - Front Exterior  Completing the framing of the room addition - Side Exterior  Completing the framing of the room addition - Back Exterior
Completing the framing of the room addition - Front Exterior

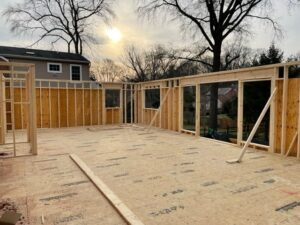

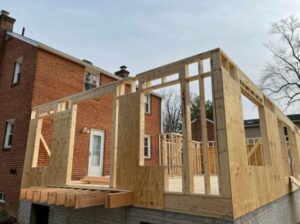

3: Framing the walls of the room addition
Framing the walls of the room addition  Framing the walls of the room addition
Framing the walls of the room addition  Framing the walls of the room addition
Framing the walls of the room addition  Framing
Framing the walls of the room addition  Framing the walls of the room addition

2: Forming foundation walls
Forming foundation walls Forming foundation walls Forming foundation walls
Forming foundation walls Forming foundation walls Forming foundation walls
Forming foundation walls Forming foundation walls Forming foundation walls
Forming foundation walls

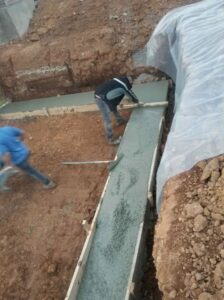

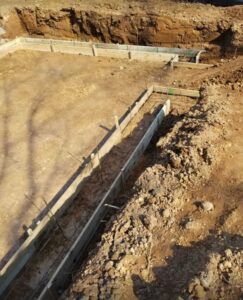

1: Footings are poured, an important part of foundation construction
Footings  Footings with concrete

BEFORE:

BEFORE

Back of the house before demolition, end of February 2022
